Siting Process





When a large-scale solar or wind energy project is proposed in Wisconsin, a specific state review process determines whether it can move forward. Understanding how that process works — and where the public has a voice — is one of the most important things a community can do to prepare.

This page walks through the Public Service Commission (PSC) review process step by step, explains when and how community members can submit comments, and describes what local governments can do even when they don’t have final permitting authority.

In Wisconsin, the large-scale permitting process depends on the project’s megawatt size.

1 megawatt (MW) of solar uses an average of 7 acres and powers about 150 homes.

An engineering plan is submitted to DNR 60+ days before the CPCN Application.

For wind projects, pre-application requirements from PSC 128 require 90 days for all projects and 180 days for turbines taller than 600 ft.

A letter notifying the public that the PSC review process has begun is mailed to property owners near the project, government officials, libraries, media, and other interested agencies and individuals, and the letter will state the level of environmental review needed, provide contact details, and may describe the environmental scoping period where comments are gathered to start the environmental review process.

Developers may also hold optional public open houses.

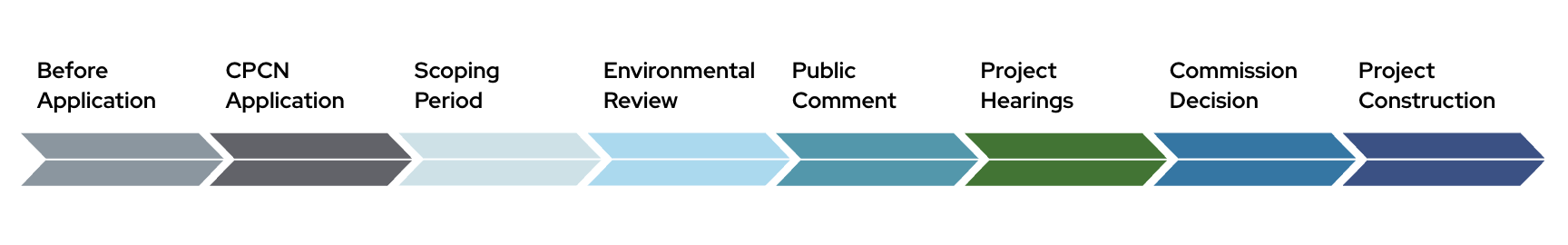

The developer applies to the PSC and the PSC confirms the application is complete, at which point a case is created and a docket is opened, and the PSC mails a letter notifying the public.

The Certificate of Public Convenience and Necessity (CPCN) application includes the project overview, a technical description of the project, project maps, construction sequence, potential impacts on natural and community resources, local government impacts, landowners affected and public outreach, waterway/wetland permitting activities, and DNR information on erosion control and stormwater management plans.

Utility-proposed projects may also require an Agricultural Impact Statement from the Wisconsin Department of Agriculture, Trade and Consumer Protection (DATCP).

There are multiple opportunities to get involved in the siting review process. Local government, organizations, and individuals can read the notification letter and project application, attend public information meetings and any PSC scoping meetings, submit comments to the PSC, review and comment on environmental reports, and speak at PSC public hearings. There are several windows for public comment on any PSC reviewed energy generation project.

If you give public testimony, be clear about who you are, how you are connected to the case, your perspective and why you feel that way, and suggest a reasonable alternative if possible.

See the PSC’s page on participating in the siting process, including requirements of a public comment and suggestions for making effective comments.

Once a project has a CPCN, as well as any required federal, state and local permits, they can begin construction.

Permitting Process Flow Chart

For a deeper dive, this flow chart created by the Wisconsin Legislative Council shows the PSC and DNR permitting process for large electric generating facilities.
